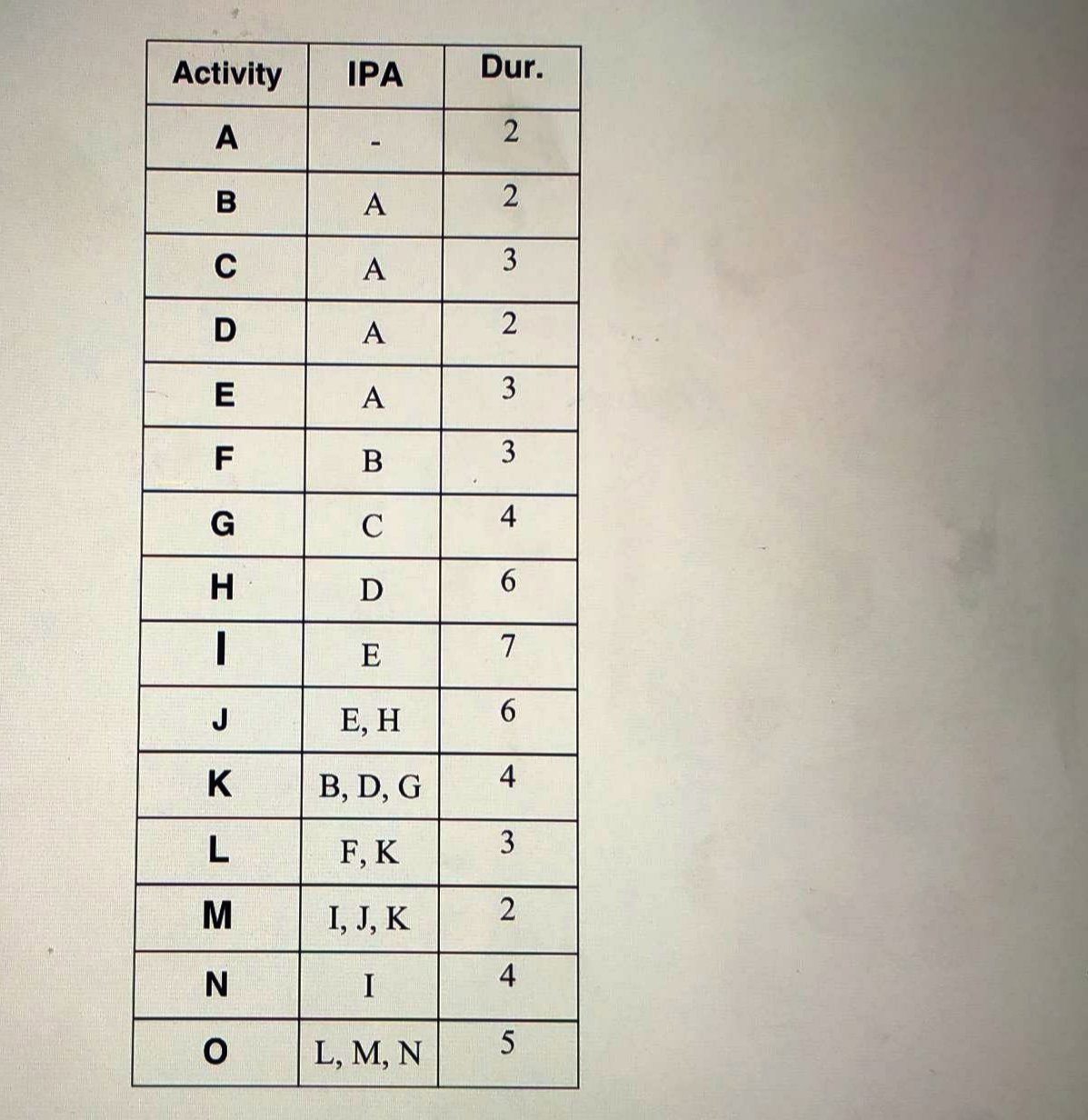

Draw the following network using the arrow diagram. Preform the CPM calculations and find the TF and FF for each activity and indicate the critical activity.
